Mapping Your Kitchen Transformation Journey

Mapping Your Kitchen Transformation Journey

Before you even think about picking up a hammer, it's crucial to understand the scope of your kitchen remodel. This initial assessment is the bedrock of your kitchen remodel timeline. It's about honestly evaluating your current kitchen and picturing your dream kitchen. This involves thinking about not just how you want it to look, but also how you want it to function and how your family actually uses the kitchen space. For a more in-depth look at the remodeling process, check out our comprehensive guide to kitchen remodels.

Are you envisioning a complete transformation, changing the entire layout and replacing everything including the plumbing? Or are you thinking of a partial update, perhaps focusing on new cabinets and countertops while keeping the existing layout? Maybe you just need a cosmetic refresh with new paint, hardware, and lighting. Each of these scenarios will significantly impact the projected timeline.

Defining Your Project Scope

Defining your project scope accurately is vital for creating a realistic kitchen remodel timeline. This means prioritizing your must-have features versus your wishlist items. Do you absolutely need that professional-grade range, or will a standard model do the job? Balancing your desires with your practical needs helps prevent budget overruns and keeps your project on track. Successfully managing a kitchen remodel requires careful planning and understanding the potential challenges. For tips on streamlining the construction process, consider exploring strategies for construction business improvements.

Understanding why you want to remodel also helps shape the timeline. Around 40% of homeowners renovate their kitchens because they’re unhappy with the way their current kitchen looks. This emphasis on aesthetics often leads to projects ranging from minor updates to full-scale renovations. Other common reasons for remodeling include improved functionality, increased home value, and adapting to a family’s changing needs. You can find more detailed statistics here. These factors all influence the complexity of the project and, as a result, how long it will take. Understanding your motivation helps set realistic expectations for the timeline.

Pre-Construction: Designing Your Dream Kitchen (2-6 Weeks)

The pre-construction phase, typically spanning 2-6 weeks, is the cornerstone of a successful kitchen remodel. It's where your dream kitchen begins to take shape, and potential issues are addressed before they escalate into costly problems. This crucial stage involves close collaboration with designers, careful selection of materials, and navigating the permit process. For a comprehensive guide on planning your remodel, check out this helpful resource: How to plan a kitchen remodel.

Initial Consultations and Design Development

The first step involves meeting with designers to discuss your vision for the space. This initial consultation goes beyond mere aesthetics. It's about understanding how your family uses the kitchen, identifying essential features, and incorporating your lifestyle into the design. Skilled designers can translate your ideas into a functional and beautiful layout.

Material Selection and Budgeting

Next comes the exciting process of choosing materials. Selecting cabinets, countertops, flooring, and backsplash involves carefully balancing style and practicality. Durability and maintenance requirements are key factors for long-term satisfaction. Thinking about organization upfront is beneficial; consider these kitchen clutter solutions to manage everyday mess. This is also the time to finalize your budget, ensuring your design choices align with your financial resources.

Permits and Contractor Selection

Securing necessary permits can be a time-consuming hurdle. Understanding local building codes and regulations is crucial. Working with experienced professionals can help streamline this process. Choosing the right contractor is another vital step. This involves interviewing candidates, evaluating bids, and checking references. Beyond price, consider their experience, communication style, and project management skills.

Industry data reveals that kitchen remodels account for a significant 38% of all home renovation projects in the 2025 outlook, highlighting the importance homeowners place on their kitchens. Learn more about kitchen remodel trends.

Building a Realistic Timeline

A practical kitchen remodel timeline should include buffer time for unforeseen delays. Unexpected issues, such as material backorders or permit delays, can and do occur. Building in flexibility helps manage these challenges and keeps the project on track.

To illustrate a typical demolition and preparation schedule, let’s examine the following table:

Pre-Construction Phase Timeline Breakdown

A detailed breakdown of tasks and their typical duration during the planning and design phase

Task Typical Duration Key Considerations
Initial Consultations 1-2 weeks Defining project scope, budget, and design preferences
Design Development 1-2 weeks Finalizing layout, material selections, and 3D renderings
Material Procurement 2-4 weeks Ordering and confirming delivery of all materials
Permitting 1-3 weeks Submitting applications and obtaining necessary approvals
Contractor Selection 1-2 weeks Interviewing, reviewing bids, and verifying references

This table outlines the key tasks within the pre-construction phase and their estimated durations. Note that the permitting process can be particularly variable, depending on local regulations. Securing materials can also take longer if items are custom-ordered or experience backorders.

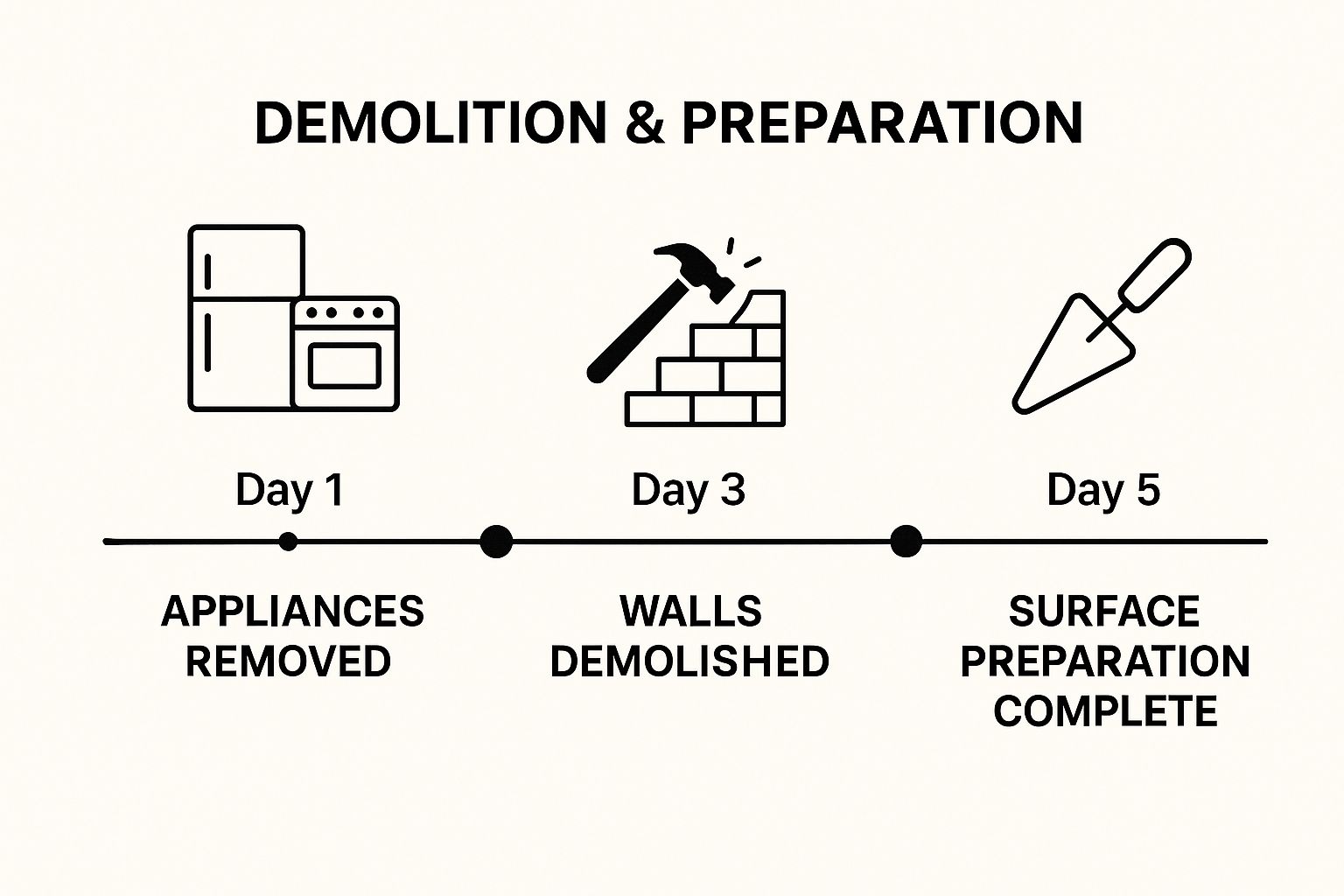

Infographic about kitchen remodel timeline

This infographic provides a simplified view of the demolition and preparation timeline. Key milestones like appliance removal, demolition, and surface preparation are often completed within the first five days. This visual emphasizes the need for efficient scheduling to maintain project momentum. A well-structured demolition phase paves the way for a smooth renovation.

This detailed pre-construction phase sets the stage for a successful kitchen remodel. By investing time and effort upfront, you can minimize costly mistakes and ensure your dream kitchen becomes a reality. The next phase involves the demolition and structural work.

Demolition & Structural Work: Making Way for New (1-2 Weeks)

Demolition & Structural Work

The demolition phase, spanning one to two weeks, is where your kitchen remodel dreams begin to take shape. This crucial step sets the stage for the exciting transformation ahead. It’s also the most disruptive part of the project, so careful planning and preparation are key to minimizing inconvenience.

Preparing for Demolition

Before demolition begins, protecting your home from dust and debris is paramount. Adjacent rooms should be shielded with plastic sheeting and drop cloths. Setting up a temporary kitchen elsewhere in your house is also essential. A mini-fridge, microwave, and coffee maker can help maintain a sense of normalcy during this time.

The Demolition Process

A systematic approach to demolition is vital for preventing unnecessary damage. Experienced contractors typically begin by disconnecting and removing appliances. Then, cabinets and countertops are carefully dismantled. Finally, any planned wall removal takes place, with careful attention paid to potential structural elements.

Managing Debris and Waste

Demolition generates significant waste. Reputable contractors will handle this responsibly, often sorting materials for recycling or proper disposal. Familiarizing yourself with local regulations for construction waste is also helpful. This ensures efficient and environmentally sound waste management.

Addressing Structural Modifications

Demolition sometimes uncovers unexpected structural issues. Rotted wood or inadequate support beams, for example, might be discovered once walls are opened. Such findings can impact your kitchen remodel timeline and budget. Consulting a structural engineer is crucial if significant modifications are needed. Their expertise guarantees that changes are made safely and in compliance with building codes.

Common Demolition Challenges

Several issues can arise during demolition. Discovering asbestos in older homes, encountering unexpected plumbing or electrical lines, or finding unforeseen load-bearing walls are just a few examples. These can potentially extend the demolition phase. However, proactive planning and a skilled team can help navigate these obstacles effectively.

The demolition and structural work phase, while disruptive, is essential for achieving your dream kitchen. Careful planning, open communication with your contractor, and a degree of flexibility will help this phase run smoothly, keeping your kitchen remodel timeline on track. Once demolition is complete, the focus shifts to the critical Mechanical, Electrical, and Plumbing (MEP) systems.

Behind the Walls: MEP Systems That Power Your Kitchen (2-3 Weeks)

After the demolition phase, the crucial behind-the-scenes work begins. This 2-3 week period focuses on the Mechanical, Electrical, and Plumbing (MEP) systems, the core infrastructure of a functional kitchen. This stage is a vital part of any successful kitchen remodel timeline, ensuring your new kitchen operates smoothly for years to come.

Electrical System Upgrades

This phase often begins with the electrical work. A well-planned electrical system is essential. It's not just about the number of outlets, but their strategic placement based on your cooking habits and appliance locations.

Think about dedicated circuits for power-hungry appliances like ovens and microwaves. Under-cabinet lighting can also make a big difference, eliminating shadows on your countertops. Addressing these details now prevents issues later.

Plumbing and Ventilation

Next comes plumbing. This may involve rerouting pipes for a new sink or adding lines for a dishwasher or ice maker. Planning ahead with your plumbing is a wise decision.

Consider installing individual shut-off valves for appliances. This allows for isolated repairs without shutting down your entire water supply. Proper ventilation is also key. A high-powered range hood effectively removes cooking fumes, improving indoor air quality. Addressing ventilation early on ensures a healthy and pleasant kitchen environment.

The kitchen and bath remodeling industry is continually growing. The industry projected $235 billion in revenue for 2025, with remodeling spending estimated to increase by 2.6%. You can find further statistics here. This underscores the importance homeowners place on efficient, modern kitchens.

Inspections and Documentation

Throughout the MEP phase, anticipate several inspections. Electrical, plumbing, and mechanical systems must comply with local building codes. A qualified contractor will navigate this process, ensuring compliance.

Meticulous documentation is essential. Keep records of permits, inspection reports, and any modifications to the original plan. These records will be invaluable in the future.

Technology Integration

Modern kitchens often include smart technology, from smart appliances to integrated sound systems. Planning for these during the MEP phase streamlines installation and ensures seamless integration.

Running wiring for internet access, speakers, and other smart home devices early in the process minimizes future modifications.

The MEP phase, though largely unseen, is crucial to a successful kitchen remodel timeline. It’s an investment in the functionality, safety, and long-term enjoyment of your new kitchen, forming the foundation for the visible transformation to come.

The Visual Transformation: From Bones to Beauty (3-4 Weeks)

Kitchen Installation

This 3-4 week phase is where your kitchen truly begins its metamorphosis. With the behind-the-scenes plumbing, electrical, and structural work completed, the focus shifts to installation. This is where your vision starts to take shape, transforming the space from a construction site into a functional kitchen. This stage of the kitchen remodel timeline breathes life into your design.

Cabinet Installation: The Foundation of Your Kitchen

Cabinet installation is the cornerstone of this phase. It forms the base upon which all other elements will be built. Countertops, appliances, and other fixtures all depend on the precise placement and stability of the cabinets. This sequential approach is essential. Imagine trying to install countertops before the cabinets – it simply wouldn't work!

Countertop Fabrication and Installation: A Critical Milestone

Once the cabinets are securely in place, the countertop process begins. This involves creating a template, taking meticulous measurements to guarantee a perfect fit. Then, the chosen countertop material—whether it's granite, quartz, or another surface—is fabricated according to those specifications. Finally, the fabricated countertop is installed. This step can significantly influence your kitchen remodel timeline. Choosing a readily available material can help avoid delays.

Flooring Installation: Timing is Everything

Flooring installation strategically follows the cabinet and countertop installation. This sequence minimizes the risk of damaging the new flooring. Protecting your new floor from potential scratches or damage during the other installations is crucial. This careful scheduling prevents costly mistakes and rework.

Managing Materials and Deliveries

Efficient project management is essential during this busy period. Coordinating deliveries of appliances, fixtures, and other materials requires careful planning and organization. Proper storage of these items is vital to protect them from damage and ensure they are readily accessible when needed. This streamlined process helps the project stay on schedule.

Homeowner Involvement: Balancing Oversight with Trust

Maintaining open communication with your contractor is key, but micromanaging can hinder the project's flow. Trusting your contractor’s expertise, while remaining available for important decisions, is crucial for a smooth process. Being accessible for questions and approvals will keep the kitchen remodel timeline on track without unnecessary delays.

To illustrate the flow of this phase, let’s take a look at the typical installation sequence and estimated durations:

Installation Phase Sequence and Timeline
Chronological breakdown of installation tasks with typical timeframes

Installation Step Typical Duration Dependencies Potential Delays
Cabinet Installation 3-5 days Completed MEP systems Damaged cabinets, incorrect measurements
Countertop Template 1 day Installed cabinets Contractor scheduling conflicts
Countertop Fabrication 1-2 weeks Countertop template Material backorders, fabrication errors
Countertop Installation 1-2 days Fabricated countertops Incorrect fit, damage during installation
Flooring Installation 2-3 days Installed cabinets & countertops Material availability, subfloor preparation issues
Appliance Installation 1-2 days Completed plumbing & electrical Delivery delays, damaged appliances

As this table shows, each step is dependent on the successful completion of the previous one. A delay in one area can have a ripple effect, impacting the overall kitchen remodel timeline. Understanding this interdependence allows homeowners to anticipate potential challenges and collaborate effectively with their contractor for timely solutions.

This 3-4 week phase marks a significant visual shift in your kitchen remodel. By understanding the process, effectively managing materials, and maintaining clear communication with your contractor, you can ensure a smooth transition towards completing your dream kitchen. The following stage will focus on the finishing touches and final systems checks, bringing all the elements together.

Bringing It All Together: Final Touches & Systems Test (1-2 Weeks)

This 1-2 week phase marks the exciting culmination of your kitchen remodel. It's where disparate elements merge into a cohesive, functional space. Beyond aesthetics, this phase ensures every system operates flawlessly, and the finishing touches truly elevate your kitchen. This is the refinement stage of your kitchen remodel timeline.

Appliance Installation and Hookups

This phase typically begins with appliance delivery and installation. Coordinating these deliveries with your contractor is essential for a seamless process. Gas connections and electrical hookups should always be handled by qualified professionals to guarantee safety and proper function. Rushing these crucial connections can compromise safety and create future problems. Professional expertise is paramount; this is not the time for DIY shortcuts.

The Punch List: Ensuring Quality and Completion

The punch list is a crucial part of this phase. This involves a systematic walkthrough of your new kitchen with your contractor, meticulously noting any incomplete or unsatisfactory work. Document everything, from minor paint touch-ups to drawer malfunctions. A thorough punch list ensures the work meets your standards before final payment.

Systems Testing: Ensuring Everything Works

Now for the exciting part: testing your new kitchen! Run appliances through their cycles, check plumbing for leaks, and verify the electrical system. This comprehensive check ensures everything operates as expected. Imagine moving back into your kitchen only to discover a drainage issue with the dishwasher – testing prevents such frustrations.

Final Touches: Cabinet Hardware, Lighting, and Paint

With systems verified, it's time for the final touches. Installing cabinet hardware, positioning light fixtures, and completing any remaining paint touch-ups transform your kitchen from functional to finished. These details elevate the overall aesthetic and complete the space.

Preparing for the First Meal

This phase transcends mere completion; it's about the anticipation of using your new kitchen. Picture preparing your first meal in this transformed space. This signifies the true end of your kitchen remodel timeline and the start of a new chapter. From initial vision to this final stage, your patience and planning have culminated in a beautiful and functional kitchen. For a comprehensive checklist, refer to this kitchen renovation checklist. This resource ensures a smooth transition into enjoying your new kitchen.

This final 1-2 week phase is crucial for a successful kitchen remodel. Prioritizing detailed systems checks, addressing punch list items promptly, and adding those final touches will allow you to confidently transition into enjoying your new kitchen. The culmination of your kitchen remodel timeline is a space designed for beauty and functionality, ready to become the heart of your home.

Navigating Detours: Managing Common Timeline Challenges

Even the most meticulously planned kitchen remodels can encounter unexpected obstacles. Understanding these potential roadblocks and developing strategies to address them is crucial for a successful renovation. This section explores common kitchen remodel timeline challenges and provides practical advice for navigating them.

Material Delays: A Common Culprit

Material backorders are a frequent source of delays. Appliances, cabinets, and countertops can sometimes have long lead times. A sudden surge in demand for a particular countertop style, for example, can push delivery dates back several weeks. This highlights the importance of early material selection and ordering during the pre-construction phase.

If possible, choose readily available materials or be prepared for potential wait times. Having a backup plan, such as a second-choice material, can help mitigate delays and keep your kitchen remodel timeline on track.

Inspection Failures: Addressing Setbacks

Inspection failures can also disrupt your schedule. A failed plumbing inspection, for instance, will require corrections and a re-inspection, adding time to the overall project. Working with a reputable and experienced contractor like Sinclair Cabinets minimizes this risk.

Experienced contractors are knowledgeable about local building codes and ensure their work meets these standards from the beginning. Maintaining open communication with inspectors can also help prevent surprises.

Unexpected Structural Issues: Contingency Planning

Demolition can uncover hidden problems. Discovering a load-bearing wall where you envisioned an open concept or finding rotted subflooring can necessitate significant plan changes and extend your kitchen remodel timeline.

Having a contingency fund in your budget helps address these unexpected expenses and allows for necessary plan adjustments. Think of this as your project's safety net, offering financial flexibility for unforeseen issues. You might be interested in: How to master your kitchen renovation checklist.

Contractor Scheduling Conflicts: Maintaining Momentum

Contractor availability can also affect your kitchen remodel timeline. Scheduling conflicts, whether due to other projects or unforeseen circumstances, can cause delays.

Regular communication and clear expectations from the outset are vital. Establishing a project schedule with defined milestones helps keep everyone aligned. Additionally, having a backup plan for critical tasks, such as identifying a substitute electrician if your primary contractor becomes unavailable, can help maintain project momentum.

Decision Paralysis: Streamlining the Process

Sometimes, homeowners themselves can cause delays. Indecisiveness about paint colors, tile patterns, or fixture styles can create approval bottlenecks that slow the project down.

Creating a decision-making framework early on, perhaps by setting deadlines for each decision, helps prevent these holdups. Gathering inspiration images and samples in advance also facilitates quicker decisions.

Documentation: Protecting Your Interests

Throughout the remodel, meticulous documentation is essential. Keeping records of change orders, material receipts, and contractor communication protects your interests if disputes arise.

Detailed documentation provides a clear record of decisions made, materials used, and any changes to the original plan, ensuring transparency and accountability.

Managing Stress and Maintaining Perspective

Kitchen remodels can be stressful. Living in a construction zone, managing unexpected delays, and making numerous decisions can take its toll.

Maintaining open communication with your contractor, setting realistic expectations, and practicing self-care can help manage stress and maintain perspective. Remember, your dream kitchen is the ultimate goal. Focusing on that vision can help navigate the inevitable challenges.

Navigating these common challenges requires proactive planning, flexibility, and open communication. By anticipating potential roadblocks and developing strategies to address them, you can successfully manage your kitchen remodel timeline and create the kitchen of your dreams. Let Sinclair Cabinetry, with over 35 years of experience crafting custom cabinetry solutions, help guide you through this exciting transformation. Visit their website to learn more.
